DPH is pleased to announce the new immunization information system (IIS) for South Carolina. SIMON will be a dynamic, and a complete IIS that ensures South Carolinians are protected from vaccine-preventable diseases by providing direct support to health care providers to deliver immunization services and increase our vaccine coverage rates.

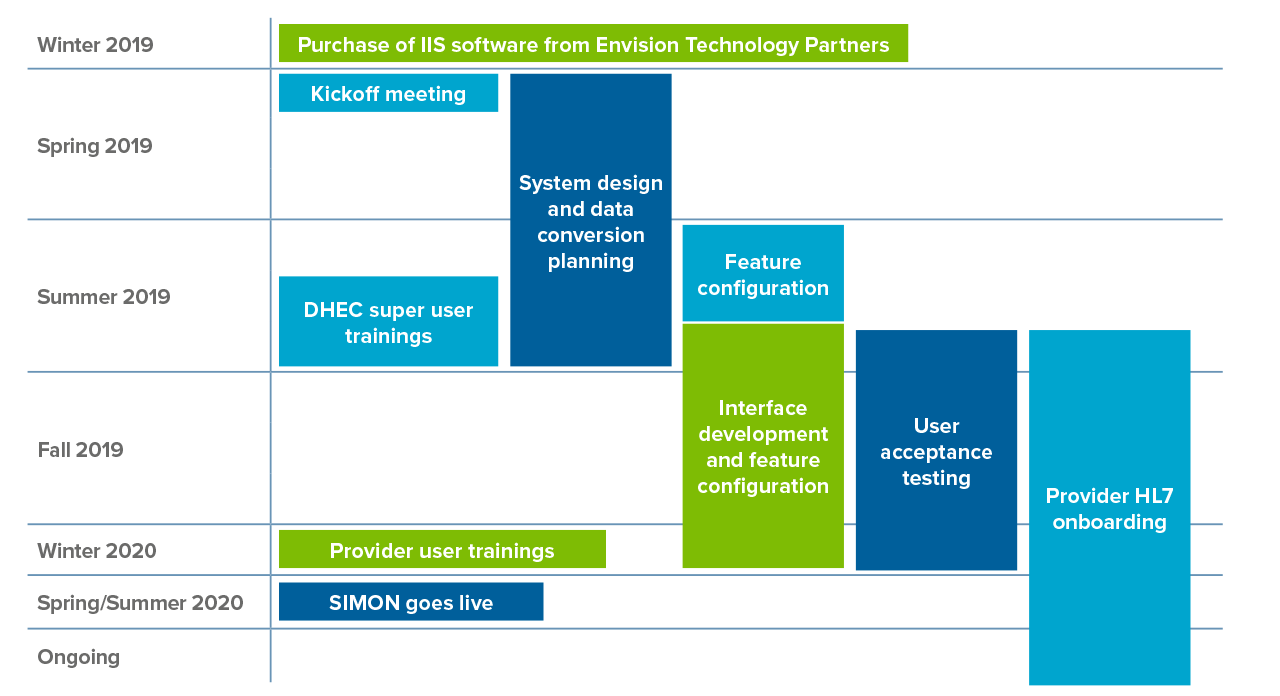

The projected timeline for project milestones are:
- Winter 2019
- Purchase of IIS software from Envision Technology Partners - Complete
- Spring 2019
- IIS Kickoff meeting - Complete
- System Design and Data Conversion Planning - Complete
- Summer 2019
- System Design and Data Conversion Planning (continued) - Complete
- Interface Development and Feature Configuration - Complete
- Fall 2019
- Interface Development and Feature Configuration (continued) - Complete
- DHEC Super User Trainings - Complete
- User Acceptance Testing - Complete
- Provider HL7 Onboarding - In process
- Winter 2020
- User Acceptance Testing (continued) - Complete
- Provider HL7 Onboarding (continued) - In process
- Provider User Trainings
- Spring/Summer 2020
- Provider HL7 Onboarding (continued)
- SIMON Goes Live
- Ongoing
- Provider HL7 Onboarding (continued)
